You're probably in one of three situations right now. You're buying a plot with an awkward industrial past, selling a property and worrying that an old use might spook buyers, or pushing a development through planning and you've been told you need a contamination survey before anyone signs off.
That can feel murky fast. The ground looks fine. The building may even look spotless. Yet your solicitor, lender, planning officer, or environmental consultant keeps talking about desk studies, intrusive investigations, pollutant linkages, and remediation strategies.
A contamination survey is how you turn that uncertainty into a practical decision. It tells you whether the land presents a real risk, what kind of risk it is, and what that means for price, planning, liability, and buildability.
Table of Contents
- Phase 1 desk study
- Phase 2 intrusive investigation
- Phase 1 vs Phase 2 contamination surveys
- Phase 3 remediation strategy
- Phase 4 verification and closure
What Is a Contamination Survey
A contamination survey is best thought of as a health check for the ground. It looks for harmful substances in, on, or under land that could affect people, buildings, groundwater, or nearby watercourses.
That matters because contamination is often invisible. A site can look tidy, level, and ready to use, while buried fill, fuel residues, metals, solvents, or asbestos-containing fragments sit below the surface. The survey's job is to find out whether there's a credible risk and whether that risk needs action.

A lot of buyers confuse this with a building survey. They aren't the same thing. A RICS building survey looks at the structure and condition of the property itself, things like movement, damp, roof defects, timber issues, and repair priorities. A contamination survey focuses on the land risk beneath and around the property.
What a contamination survey is trying to answer
In plain terms, the survey asks questions like these:
- Was the land used in a way that may have left pollutants behind such as gasworks, chemical works, metal processing, landfill, fuel storage, or industrial fill?
- Can those pollutants move through soil, dust, ground gas, or groundwater?
- Is there something that could be harmed such as future residents, construction workers, controlled waters, or gardens?
- Does the risk need more investigation or remediation before purchase, sale, lending, or development?
Practical rule: If the risk is underground, a standard building survey won't answer it.
The phrase “contamination survey” also covers more than one level of work. Sometimes the answer comes from records, maps, and a site walkover. Sometimes it needs boreholes, trial pits, and lab testing. The right scope depends on the site history and the likely exposure route.
If your concern is specifically hazardous material within the building fabric rather than the land, a separate resource like this homeowner's guide to asbestos inspection can help you understand where building-related asbestos checks fit alongside ground investigation.
Why buyers and developers shouldn't shrug it off
The practical value is simple. A contamination survey helps you decide whether to proceed, renegotiate, seek planning support, request remediation, or walk away. It turns vague suspicion into evidence you can use in a transaction.
For a buyer, that can mean avoiding inherited liability. For a seller, it can mean reducing uncertainty before a deal stalls. For a developer, it can mean giving the planning authority the information it needs in the format it expects.
The UK Legal and Standards Context
The reason contamination surveys matter so much in UK property work isn't only technical. It's legal. The current framework was created by the Environmental Protection Act 1990, with the contaminated land regime in Part IIA later implemented through the Contaminated Land (England) Regulations 2000. That framework introduced the formal test for whether land is contaminated by considering whether there's a significant possibility of significant harm or pollution of controlled waters, as noted in this reference to the Environmental Protection Act 1990 and Part IIA framework.
Why the law matters to an ordinary transaction
In practice, that means contamination isn't just “bad ground”. It becomes a legal risk when a source, a pathway, and a receptor line up. Surveyors and consultants often call this a pollutant linkage.
Here is the simple version:
- Source means the contaminant itself, such as hydrocarbons, metals, or asbestos in made ground.
- Pathway means how it can travel or how exposure can happen, such as direct contact, dust inhalation, vapour migration, or groundwater movement.
- Receptor means what could be harmed, such as residents, construction workers, crops, buildings, or water.
If one of those elements is missing, the risk picture changes. That's why a useful contamination survey doesn't stop at “there may once have been industry here”. It asks whether that historic use still creates a real present-day risk.
Land history starts the conversation. Pollutant linkage is what decides whether the issue has teeth.
This is also where liability worries people. A current owner may face a problem even if they didn't cause the original contamination. That's one reason buyers, lenders, and developers want the ground risk assessed early, before contracts are exchanged or planning conditions tighten.
For readers who are comparing different kinds of property professionals, it's also helpful to understand what RICS accreditation means. It doesn't replace environmental expertise, but it helps you distinguish chartered surveying credentials from specialist contaminated land competence.
How survey standards shape the work
A good consultant won't improvise. They work to recognised methods and structured risk assessment. That affects how the desk study is prepared, how samples are taken, how laboratory suites are chosen, and how recommendations are justified.
This is one place people get mixed up with other environmental issues. Indoor air quality standards, for example, sit in a different technical lane from contaminated land, even though both involve exposure pathways. If you're comparing those disciplines, this overview of ASHRAE and EPA metrics shows how building-environment metrics differ from land contamination assessment.
A contamination survey isn't just a cautious extra. In many UK transactions, it's part of proper risk management because it supports decisions on liability, planning, insurance discussions, land value, and remediation scope.

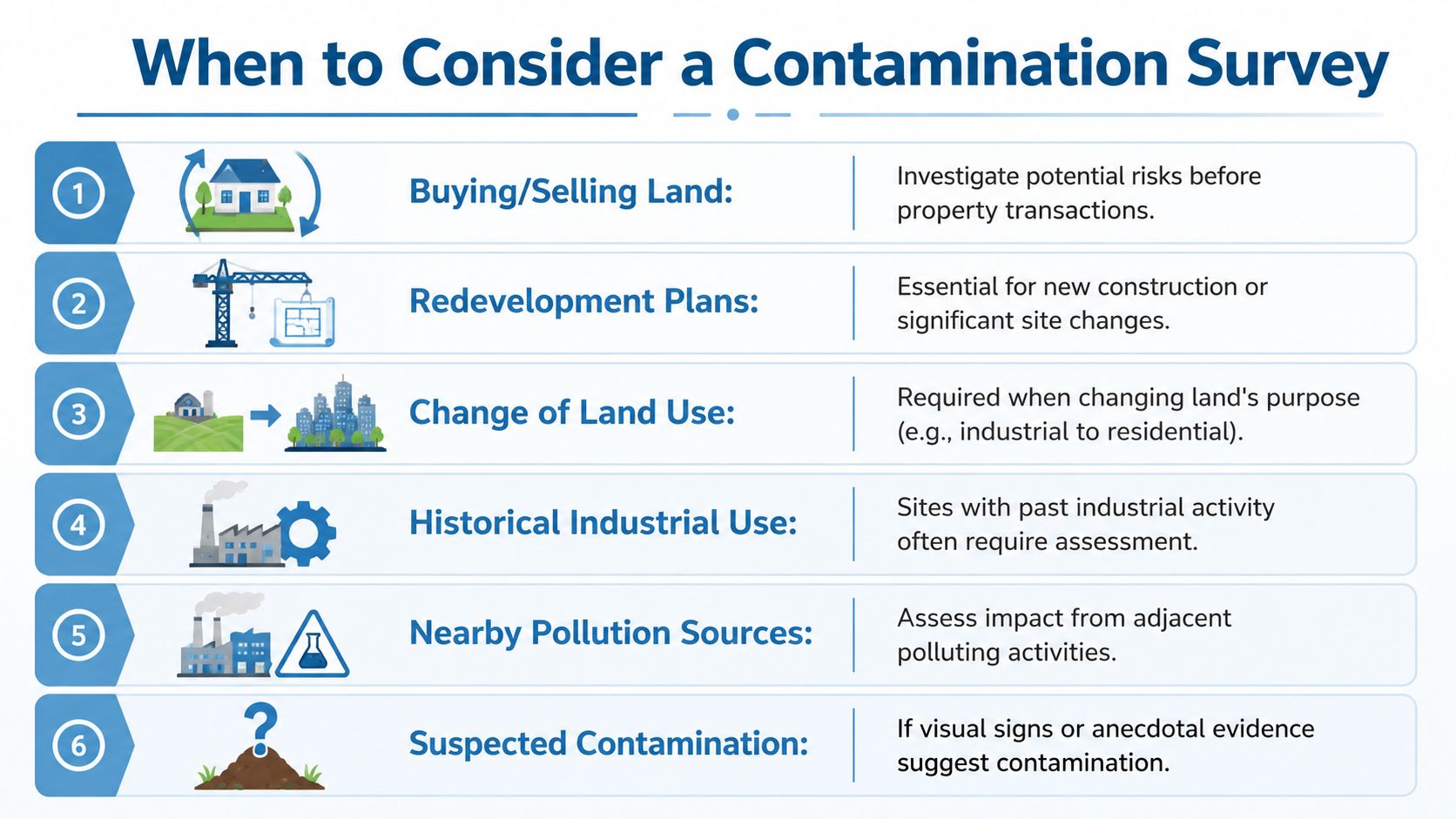

When to Commission a Contamination Survey
Clients rarely order a contamination survey purely out of curiosity. They typically commission one because something in the transaction, planning process, or site history indicates a need for clearer answers.
The reason this comes up so often is straightforward. The Environment Agency has estimated that around 300,000 hectares of land in England and Wales are potentially affected by historical industrial contamination, with roughly 10,000 sites regarded as likely to pose a serious threat, according to this reference to the Environment Agency estimate on historically affected land. That's why land investigation sits at the centre of development risk management instead of the edge of it.

Common transaction and development triggers
Some triggers are obvious. Others are easy to miss until a lender, planner, or consultant points them out.
- Former industrial or commercial use: Old petrol stations, engineering works, print works, gasworks, depots, dry cleaners, railway land, and scrapyards often justify closer review.
- Brownfield redevelopment: If you're changing a previously developed site into housing, mixed use, or sensitive end use, the planning authority may expect a structured contamination assessment.
- Change to a more sensitive use: A site that was acceptable for storage or industry may need more scrutiny if it will become homes, a school setting, allotments, or gardens.
- Lender or solicitor concern: Environmental searches sometimes flag potentially contaminative uses nearby or on the site itself. That doesn't prove contamination, but it often triggers follow-up.
- Local authority planning conditions: Many permissions include conditions that require investigation, remediation proposals, and verification before occupation.
- Neighbouring risk sources: Land can be affected by what's next door or what used to be nearby, especially where made ground, migration, or groundwater pathways are possible.
If you're buying, treat these triggers as decision points, not background noise. The earlier you investigate, the more advantage you usually have.
Warning signs people often dismiss
Not every clue comes from paperwork. Some come from the site itself.
Watch for:
- Discoloured soil or unusual fill: Ashy material, fragments of brick and clinker, black staining, oily patches, or mixed demolition debris.
- Strange odours: Fuel-like, chemical, or solvent smells during excavation or on a warm day.
- Poor vegetation: Bare patches or weak growth can have benign causes, but they shouldn't be ignored on suspect land.
- Old tanks or hardstanding: Redundant forecourts, infilled basements, vent pipes, and patched surfaces can hint at former storage.
- Informal local knowledge: Neighbours often know the site used to be “the old works” long before that history appears in your file.
If a site history, a planning condition, and a lender's query all point in the same direction, delaying the survey usually just delays the problem.
A contamination survey is usually cheapest when it's used as an early filter. If the initial work clears the site, you move forward with confidence. If it raises issues, you still have time to renegotiate, redesign, add conditions to the contract, or sequence remediation sensibly.
The Contamination Survey Process Step by Step
A proper contamination survey usually follows a phased approach. That matters because the work should get more detailed only when the evidence justifies it. You don't want to pay for drilling if a thorough desk review already shows minimal risk. But you also don't want to rely on paperwork alone when the site history clearly points to buried hazards.
One of the biggest mistakes is ordering a generic investigation. The survey method needs to match the likely contaminant and exposure route. The approach for PFAS, asbestos in made ground, and fuel residues can differ significantly, as explained in this practical note on choosing the right land contamination survey approach.
Phase 1 desk study
Phase 1 is the research stage. No one starts digging yet. The consultant gathers the available evidence and builds an initial conceptual site model.
That normally includes:
- Historic mapping review: old site uses, infilled ponds, former industrial footprints, tanks, sidings, and works areas
- Environmental database checks: landfill records, pollution incidents, abstractions, discharge consents, and related constraints
- Site walkover: visual inspection for stains, vent pipes, made ground, distressed vegetation, storage areas, or suspect materials
- Preliminary risk assessment: possible sources, pathways, receptors, and whether further work is needed
The output isn't just a pile of records. It's a reasoned opinion on whether the site is low risk, needs targeted follow-up, or clearly requires intrusive investigation.
For a fuller breakdown of the sequence, this guide to soil contamination assessment is useful if you want to see how desk studies feed into later testing.
Phase 2 intrusive investigation
Phase 2 begins when records and site evidence suggest that you need actual samples. Such sampling may involve boreholes, window samples, trial pits, gas monitoring points, and groundwater checks.
The consultant designs the investigation around the suspected issue. For example:
- fuel risk may require hydrocarbon testing and vapour assessment
- made ground may need asbestos screening and soil chemistry
- controlled waters concerns may require groundwater monitoring
- development with gardens may need a closer look at direct contact risks in topsoil
Laboratory analysis then tests the samples against the contaminants of concern identified in the conceptual model. If the lab side interests you, this overview of outfitting environmental testing facilities gives a useful look at the kind of controlled environment that supports reliable environmental analysis.
Phase 1 vs Phase 2 contamination surveys
| Aspect | Phase 1 (Desk Study) | Phase 2 (Intrusive Investigation) |
|---|---|---|
| Main purpose | Identify potential contamination risks from records and site appraisal | Confirm whether contamination is present and assess its extent |
| Typical activities | Historic maps, database review, walkover survey, preliminary risk assessment | Trial pits, boreholes, sampling, gas and groundwater monitoring, laboratory analysis |
| Ground is broken | No | Yes |
| Best used when | You need an initial view for purchase, sale, or planning | The desk study shows credible pollutant linkages or planning requires testing |
| Output | Conceptual site model and recommendation for no further action or more work | Factual data, quantified risk interpretation, and remediation recommendations |
Phase 3 remediation strategy
If contamination is confirmed, the next step is deciding what to do about it. This isn't a failure. It's a management stage.
The remediation strategy sets out:
- What problem needs addressing
- Which remediation option is suitable
- How the work will be carried out
- What evidence will prove it was done properly
This is also where commercial decisions appear. A buyer may use the findings to renegotiate. A developer may revise the earthworks strategy, foundation design, or materials handling plan.
Phase 4 verification and closure
After remediation, someone has to show that the agreed works were completed and that the site now meets the required standard for its intended use. That's the purpose of verification.
Typical verification evidence can include photographs, waste transfer documentation, validation sampling, clean cover records, gas protection installation records, and an updated report for the planning authority or lender.
A contamination survey only becomes valuable in practice when the findings are turned into a decision, then into documented action.
Understanding Survey Findings and Remediation Options
The first time many clients open a contamination report, they go straight to the lab tables and panic. That's usually the least helpful place to start. What matters first is the consultant's interpretation of the risk in the context of the site's proposed use.

What the report is really telling you
Most findings fall into a practical pattern. The report usually identifies a contaminant, explains who or what could be affected, and then says whether the risk is acceptable, needs refinement, or needs remediation.
Common issues in UK property work include:
- Heavy metals: often linked to industrial activity, ash, fill materials, or historical processes
- Hydrocarbons: associated with fuel storage, garages, depots, or spills
- Asbestos in made ground: fragments mixed into infill or demolition materials
- Solvents and chemical residues: more common on some industrial and commercial sites
- Ground gases or vapours: relevant where landfill, organic fill, or hydrocarbons are involved
A result doesn't mean the whole site is unusable. It means the land has to be assessed against the intended use. Land that may be manageable beneath hardstanding can become a bigger issue if the proposal includes gardens, soft landscaping, or sensitive end users.
Buyers often hear “contamination” and assume “deal over”. In reality, the real question is whether the risk is manageable for the intended use and at what cost or with what design change.
This video gives a useful general primer on environmental site assessment and how findings are interpreted in context:
Typical remediation routes
The remedy depends on the problem. There's no single fix for every site.
- Excavation and disposal: often called “dig and dump”. Contaminated soil is removed and taken to an appropriate facility. This can be direct and effective, but it may affect programme, haulage, and disposal paperwork.
- Capping or cover systems: clean material is placed above impacted ground to break the exposure pathway. This is common where direct contact is the main concern.
- Targeted removal of hotspots: instead of treating the whole site, the works focus on specific areas such as tank zones, old pits, or highly impacted pockets.
- Gas or vapour protection measures: membranes and sub-floor measures may be used when ground gas or vapour pathways are part of the risk model.
- Treatment approaches such as bioremediation: in some cases, contaminants can be reduced or managed through treatment rather than simple removal.
The property implication is what most clients care about. If remediation is straightforward and documented properly, a site can still proceed through sale, funding, and development. The key is that the findings must translate into a plan that planners, lenders, buyers, and insurers can understand.
How to Choose a Qualified Contamination Consultant
Not every surveyor is the right person for contaminated land work. You need someone who understands environmental risk assessment, site investigation design, regulatory expectations, and report writing for planning and transactional use.
Who you actually need
Start with the basics. Look for a consultant or practice that regularly handles contaminated land assessments rather than treating them as an occasional add-on. Experience with similar sites matters more than polished marketing.
Useful signs include:
- Relevant land condition experience: especially with brownfield redevelopment, planning submissions, and intrusive investigations
- Knowledge of the local authority process: some consultants understand what local planning officers and environmental health teams usually expect in reports
- Clear scope writing: they should explain why they are recommending a desk study, intrusive work, gas monitoring, or remediation planning
- Insurance and accountability: contamination work carries real liability, so professional indemnity cover matters
- Recognised professional standing: chartered status can help, and specialist contaminated land credentials are even more relevant where available
If you want a simple framework for checking professional standing before you appoint anyone, this guide on how to verify UK surveyor credentials is a good starting point.
Questions worth asking before you instruct
A short conversation can reveal a lot. Ask direct questions and listen for practical answers.
- What similar sites have you handled recently: You want evidence of experience with former industrial land, fuel risks, made ground, or the specific issue affecting your site.
- How will you decide whether Phase 2 is needed: A good consultant should talk about site history, pollutant linkage, and proportional scope.
- Are you familiar with this council's planning requirements: Local expectations can affect report content, remediation wording, and verification evidence.
- Who interprets the lab data and writes the risk assessment: That tells you whether the technical judgement stays with an experienced person.
- Can you explain the likely outcomes in commercial terms: Buyers and developers need someone who can connect findings to price, programme, contract conditions, and planning risk.
- What exclusions are in your fee proposal: Hidden gaps cause trouble later, especially around additional visits, monitoring rounds, waste classification, or remediation sign-off.
A consultant who answers in plain language is usually easier to work with when the report lands on a buyer's desk or in front of a planning officer.
Checklist for Buyers Sellers and Developers
A contamination survey becomes most useful when you treat it as a decision tool, not just a report to file away. The checklist below is the practical version.
For buyers
- Check the site history early: If the property sits on or near former industrial land, ask your solicitor what the searches show before you commit fully.
- Make risk part of the negotiation: If contamination is suspected, consider making the purchase conditional on satisfactory investigation or use the findings to reopen price discussions.
- Ask who carries what liability: Your solicitor should explain how the contract, replies to enquiries, and any remediation records affect your position.
- Don't confuse land risk with building condition: You may need both a building survey and a contamination survey. One doesn't replace the other.
- Request the paperwork behind any previous clean-up: Ask for remediation strategies, validation reports, waste records, and planning discharge evidence if the seller says the issue was already dealt with.
For sellers
Selling a site with a known or suspected issue doesn't always mean trouble. Uncertainty is often the bigger obstacle.
- Consider a proactive survey: If the site's history is likely to raise questions, a well-prepared report can answer them before a buyer assumes the worst.
- Gather the site's history properly: Planning approvals, old site plans, tank removal records, and earlier investigations can all help.
- Disclose accurately: If you know about previous contamination work, don't leave it vague. Partial disclosure often creates more suspicion than a clear explanation.
- Be ready for sensible renegotiation: If a buyer's consultant identifies a manageable issue, the deal may still proceed if both sides have a realistic basis for discussing cost and timing.
For developers
Developers usually feel the impact most directly because contamination affects planning, programme, earthworks, foundation design, and verification.
- Align the survey with the proposed end use: Residential gardens, soft landscaping, and sensitive receptors usually demand more careful risk evaluation than hardstanding-only layouts.
- Sequence investigation before detailed design locks in: You don't want contamination surprises after drainage, cut-and-fill, or foundation assumptions are fixed.
- Read planning conditions line by line: Many conditions require phased submission of investigation, remediation, and verification documents.
- Coordinate the consultant team: Groundworkers, geotechnical engineers, environmental consultants, and planners need the same risk picture.
- Protect the paper trail: Validation documents matter almost as much as the physical remediation work because they prove compliance later.
The best time to manage contamination risk is before exchange, before planning conditions bite, and before the contractor prices the wrong job.
The strongest position, whether you're buying, selling, or developing, comes from asking one question early: what decision will this survey help me make? Once you know that, the scope, timing, and use of the report become much clearer.
If you need help finding the right professional, Survey Merchant connects property owners, buyers, and developers with qualified UK surveyors across multiple disciplines. That can be especially helpful when a transaction needs both general property advice and specialist input to manage risk clearly and quickly.
